SR 520 Portage Bay Bridge and Roanoke Lid Project Open House
On this page: Welcome! | Project overview | Project schedule | Construction progress | Piledriving progress | Building the new Portage Bay bridges | Upcoming construction | Construction near Portage Bay and Roanoke Park neighborhoods | Nighttime construction | New haul road connections | Stay in touch
Welcome to our online open house!
Major construction for the SR 520 Portage Bay Bridge and Roanoke Lid Project began in November 2024, and things look very different around Portage Bay today!
This open house provides updates on what we've done and what's to come over the next year. As we begin building more permanent elements of this project, we want to keep you informed and answer questions you might have.
Throughout the online open house, you will see visuals of the current conceptual designs. This is a Design-Build project. That means WSDOT completed the project's preliminary design, or "conceptual design." The project's design-builder, Skanska/AECOM, will finish the design and build the project. Because we're continuing to finalize the project design, the completed project may look different than what we are sharing today.
This open house is available until March 3, 2026.
Project overview

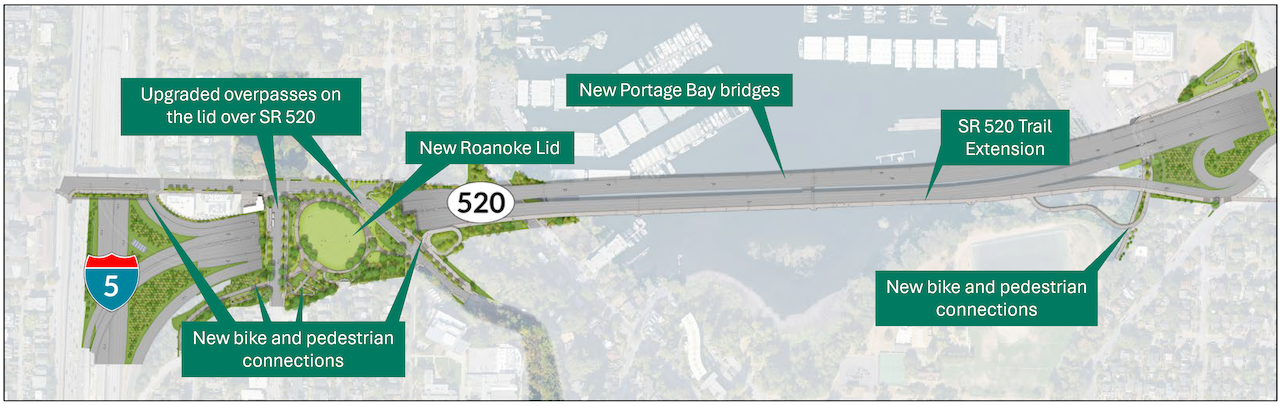

Map of major project elements.
The Portage Bay Bridge and Roanoke Lid Project will replace the old, structurally vulnerable Portage Bay Bridge with two parallel, seismically resilient bridges. The project will also build a landscaped lid over SR 520 between 10th Avenue East and Delmar Drive East, complete the highway's transit/HOV system between the Eastside and Seattle, and extend the regional SR 520 Trail across Portage Bay to the lid and local trails.
Project schedule

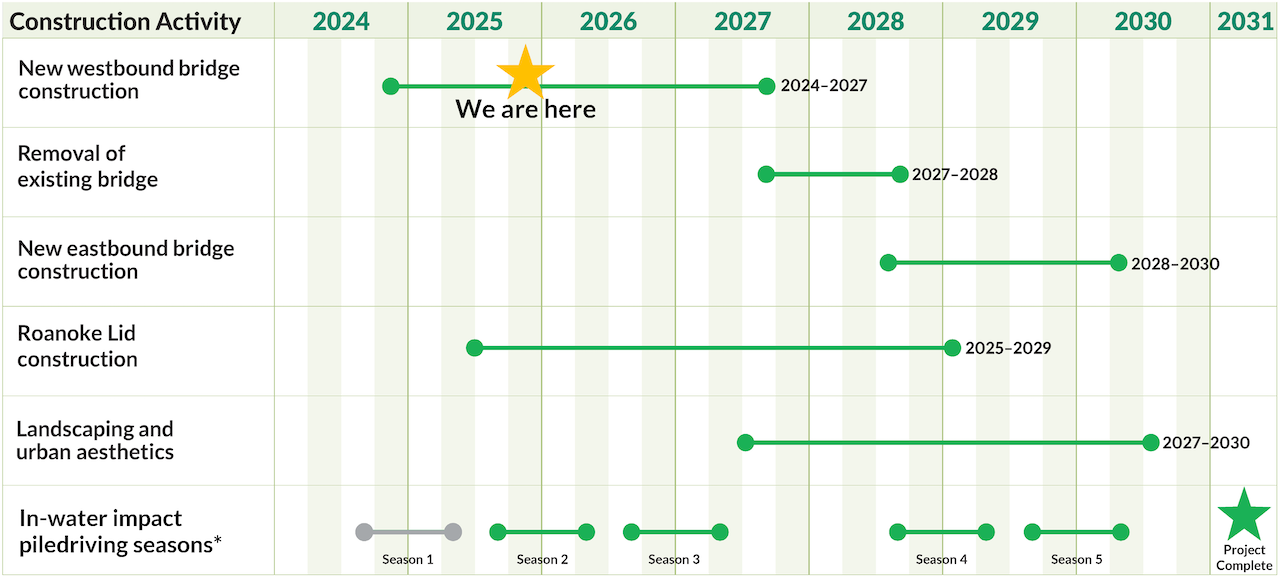

Construction began in November 2024. The project is expected to be completed in 2031. The construction schedule is subject to change.
*The in-water impact piledriving season lasts from September 1 to April 30. We will continue vibratory piledriving and have limited on-land impact piledriving year-round. Please note: Construction schedule is subject to change.
Construction progress – 2024-2025
Piledriving progress
Since we started piledriving in fall 2024, we've installed over 300 temporary piles in Portage Bay – that's about half of the total piles we need for the project based on our current design! For the next few years, we'll continue installing piles in and around Portage Bay using both impact and vibratory hammers. The 2024-2025 in-water piledriving season was our busiest season, and we expect less piledriving in future seasons.
Did you know that it's not just in Portage Bay where we're installing piles? We also have piles to install near the Bill Dawson Trail, and will install piles for temporary on- and off-ramps which we'll discuss later in this open house.
Ongoing piledriving in Portage Bay
Our second season of in-water impact piledriving began in September and will continue through April 30, 2026. We expect to install around 150 piles in Portage Bay this season.
Typical impact piledriving hours are 8 a.m. to 5 p.m. on weekdays and 9 a.m. to 5 p.m. on weekends, though we may work later into the evening if needed. We'll notify neighbors with email updates if our schedule changes.

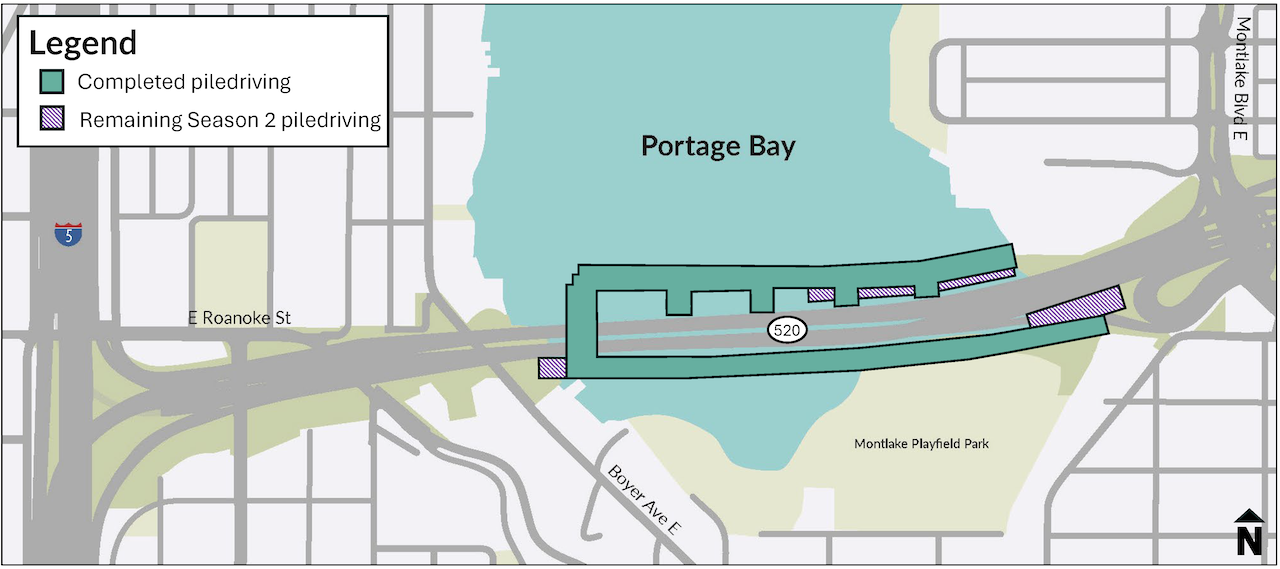

We'll continue vibrating piles around the project area year-round. See the map below for where we are installing piles during Season 2.

Map of current and upcoming piledriving activities.
| MORE ABOUT OUR PILEDRIVING SCHEDULE Our in-water impact piledriving seasons begin in September and end in April. These seasons align with the "fish window" in Portage Bay. A "fish window" is a specific time frame when in-water impact piledriving is allowed in order to minimize harm to fish populations. These windows are set by regulatory agencies, like the Department of Fish and Wildlife, and are based on when fish are least likely to spawn or migrate in a particular waterway. While we're not allowed to drive piles in the water with an impact hammer outside of the fish window, we are allowed to use an impact hammer on land and a vibratory hammer in the water year-round. |
Understanding our piledriving methods
Why we use different piledriving techniques
The piledriving method we use to install our piles depends on the type of the soil at the bottom of Portage Bay. We need to install each pile deep into the lakebed, so it is strong enough to support the weight of the work trestle surface, our crews and equipment.
The lakebed beneath Portage Bay contains both soft sediments and hard clay layers at different depths and locations. Our crews test the soil at each pile location and choose the right piledriving method based on the underground conditions. We use impact piledriving when we need to install piles through tough clay layers.

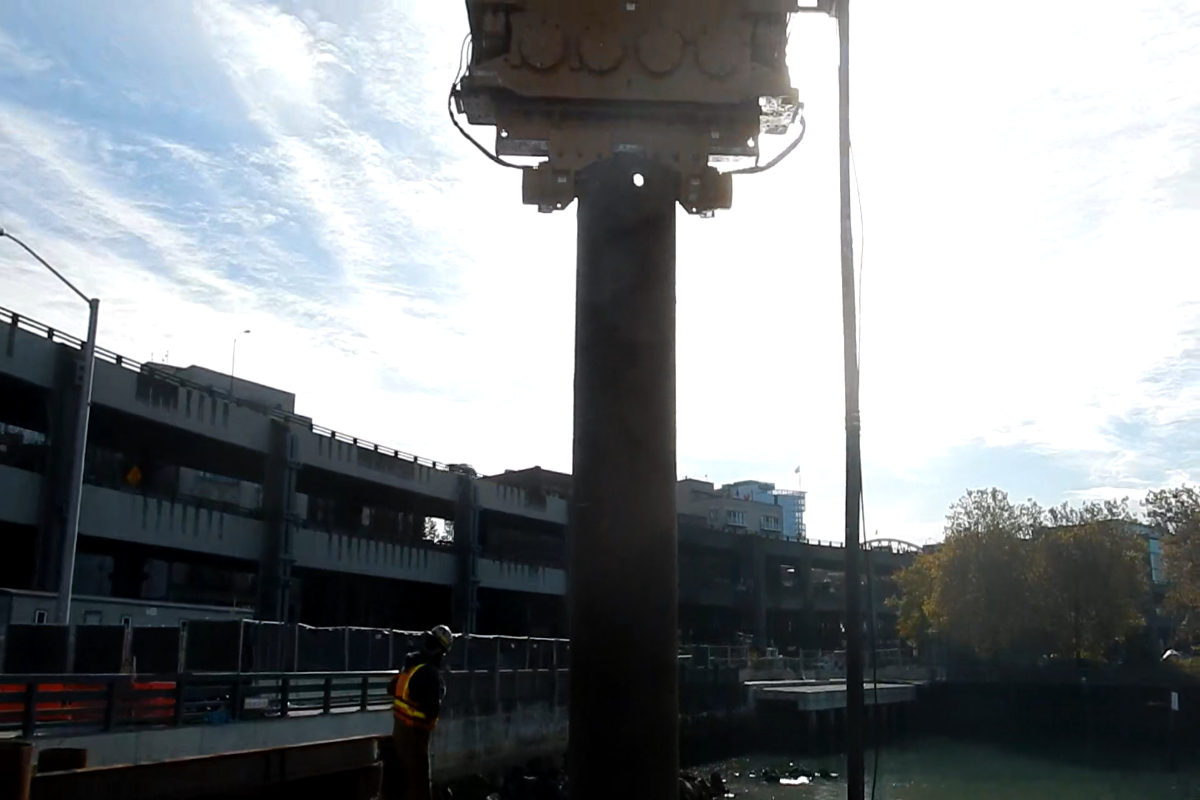

Vibratory piledriving
Vibratory hammers use rapid vibrations to "shake" piles into the ground through soft soils and sediments. This method produces continuous sound and vibration. In Portage Bay's softer clay and sediment layers, vibrations help the pile slip through the soil with less resistance. To reduce noise in the neighborhood, we use vibratory piledriving whenever possible.
Impact piledriving
Impact hammers use a heavy weight that repeatedly strikes the top of the pile, driving it through harder soil. While this method produces a sharp noise, it's the only effective way to install piles through Portage Bay's stubborn clay layers that won't give to vibration alone.
See what's below the surface in Portage Bay
These cross-section diagrams show what our construction crews might find beneath Portage Bay. The diagram on the left demonstrates soft sediment layers where vibratory piledriving can effectively shake piles into place. The diagram on the right shows dense clay layers that require impact piledriving to push through. Our steel piles are 30 inches in diameter and 100 feet long on average. We drive them into the ground until they hit dense clay or until they are deep enough to hold heavy loads.
We use different piledriving methods – or even a combination of both methods – depending on the soil conditions we find at each location in Portage Bay. See the diagrams below for typical underground conditions that shape our piledriving approach.
![]() Diagram of conditions where crews use vibratory piledriving to install piles through soft clay. | ![]() Diagram of conditions where crews use vibratory piledriving followed by impact piledriving to complete the installation through tough clay. |
Building the new Portage Bay bridges
Building the bridge foundation
A series of structures called "drilled shafts" will provide the foundation of the new Portage Bay bridges. A drilled shaft uses a larger type of pile installed deep into the clay layer beneath the lake. The casing forms the outer shells of the drilled shafts. The casings are hollow on the inside and larger than our steel piles, approximately 12' feet in diameter. To build the bridge foundation, we will:

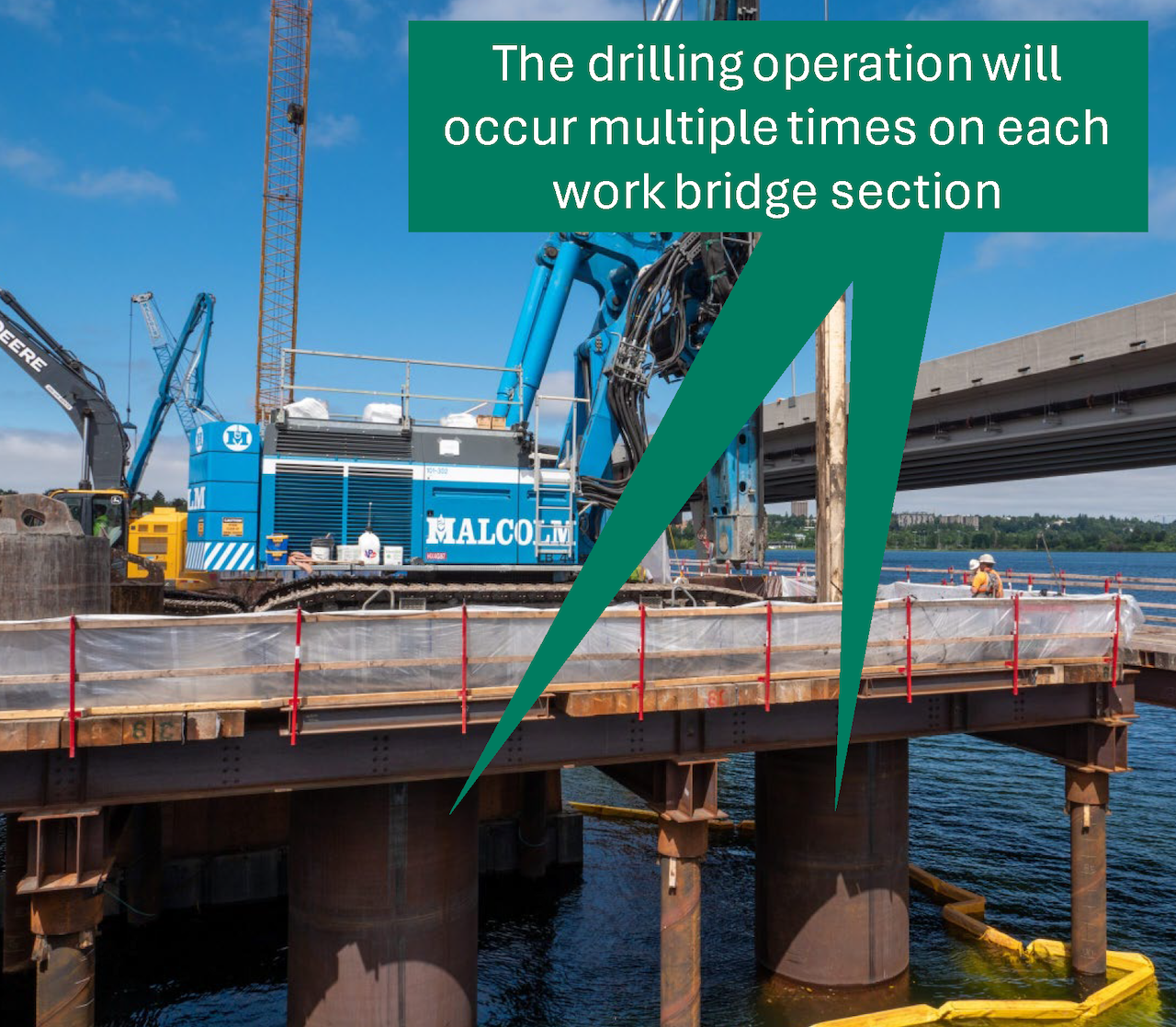

- Vibrate the casing deep into the bottom of the lake using a vibratory hammer.

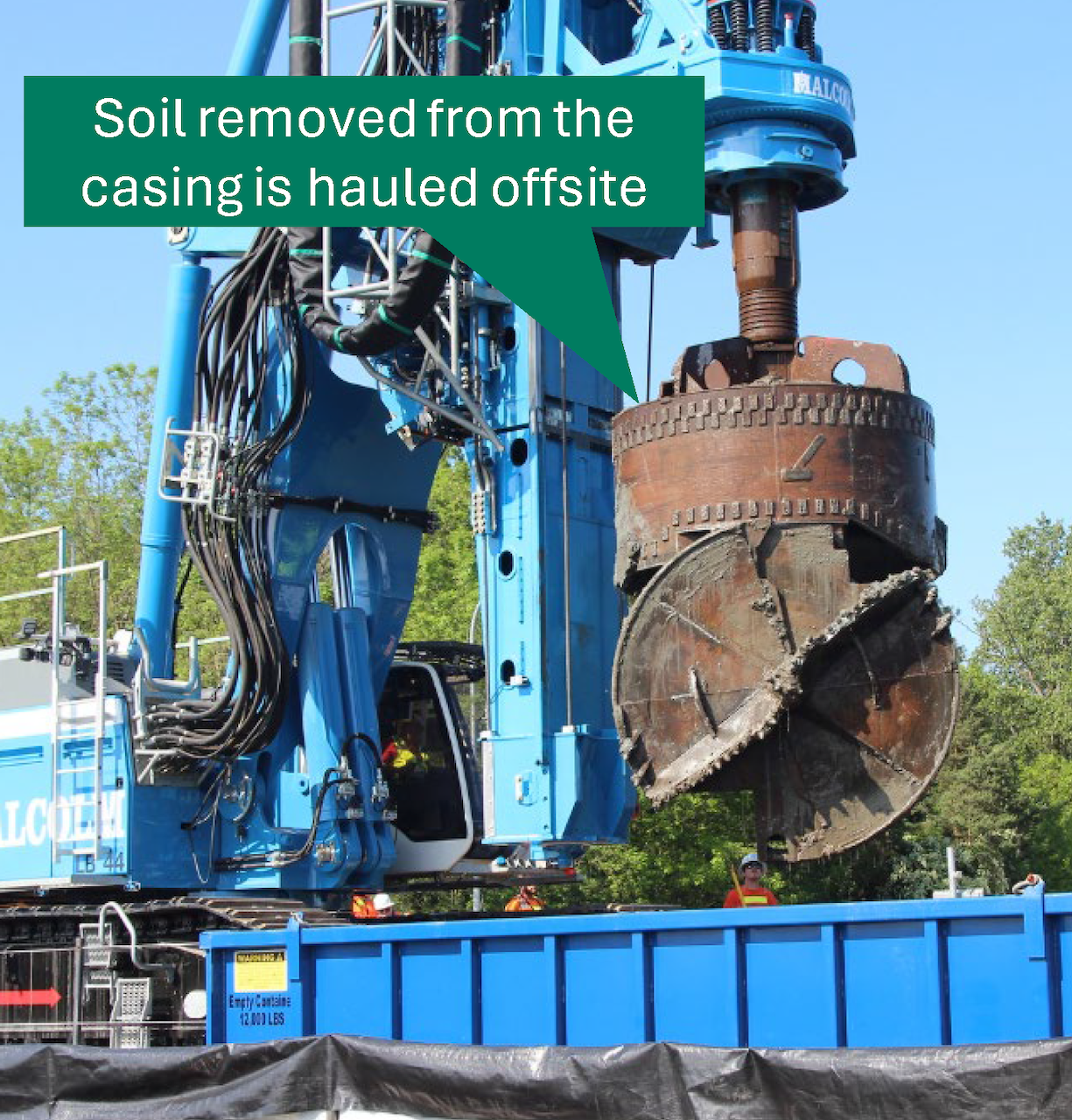

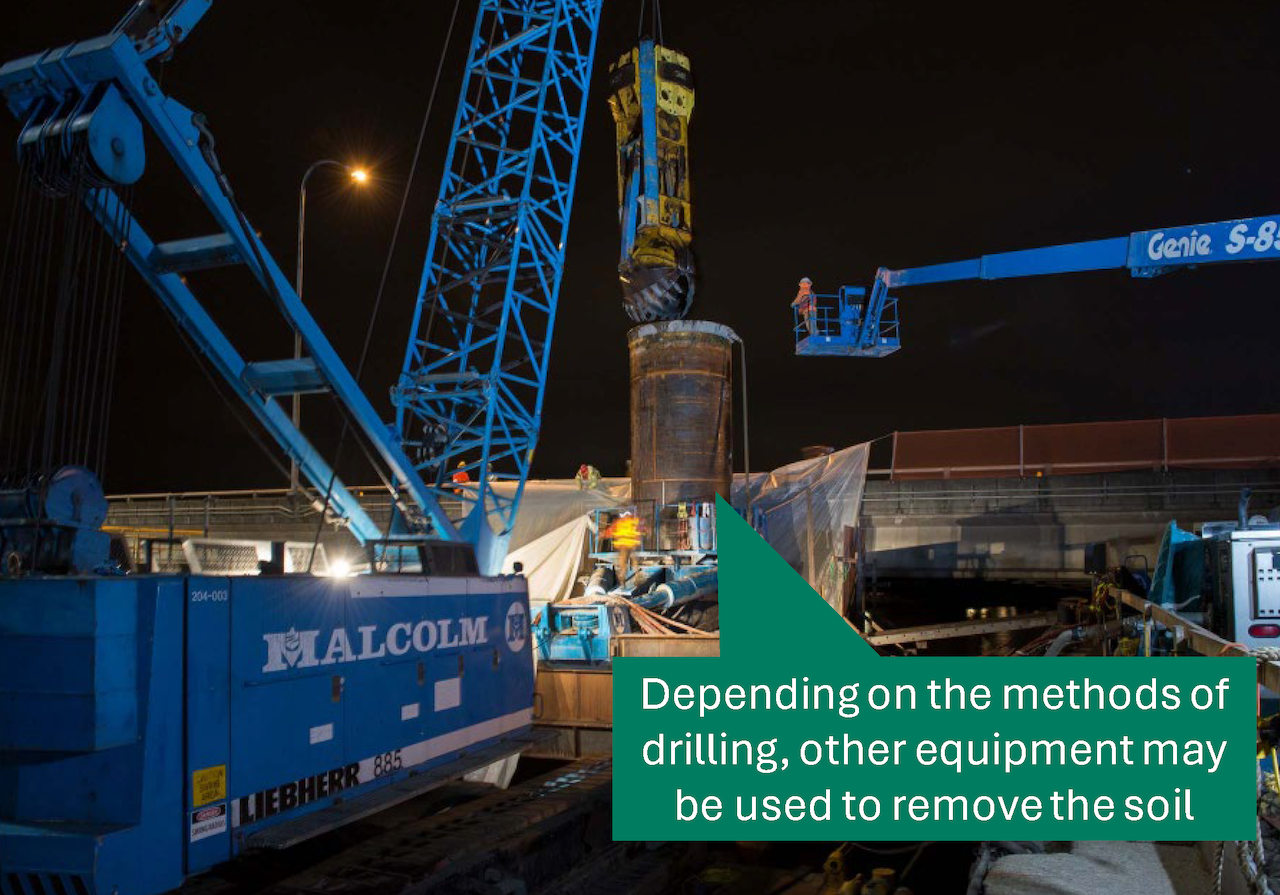

- Remove the soil from the inside of each casing by using a crane-mounted cylindrical drill (or hammer grab depending on soil conditions). The hollow casings form shafts deep into the ground.

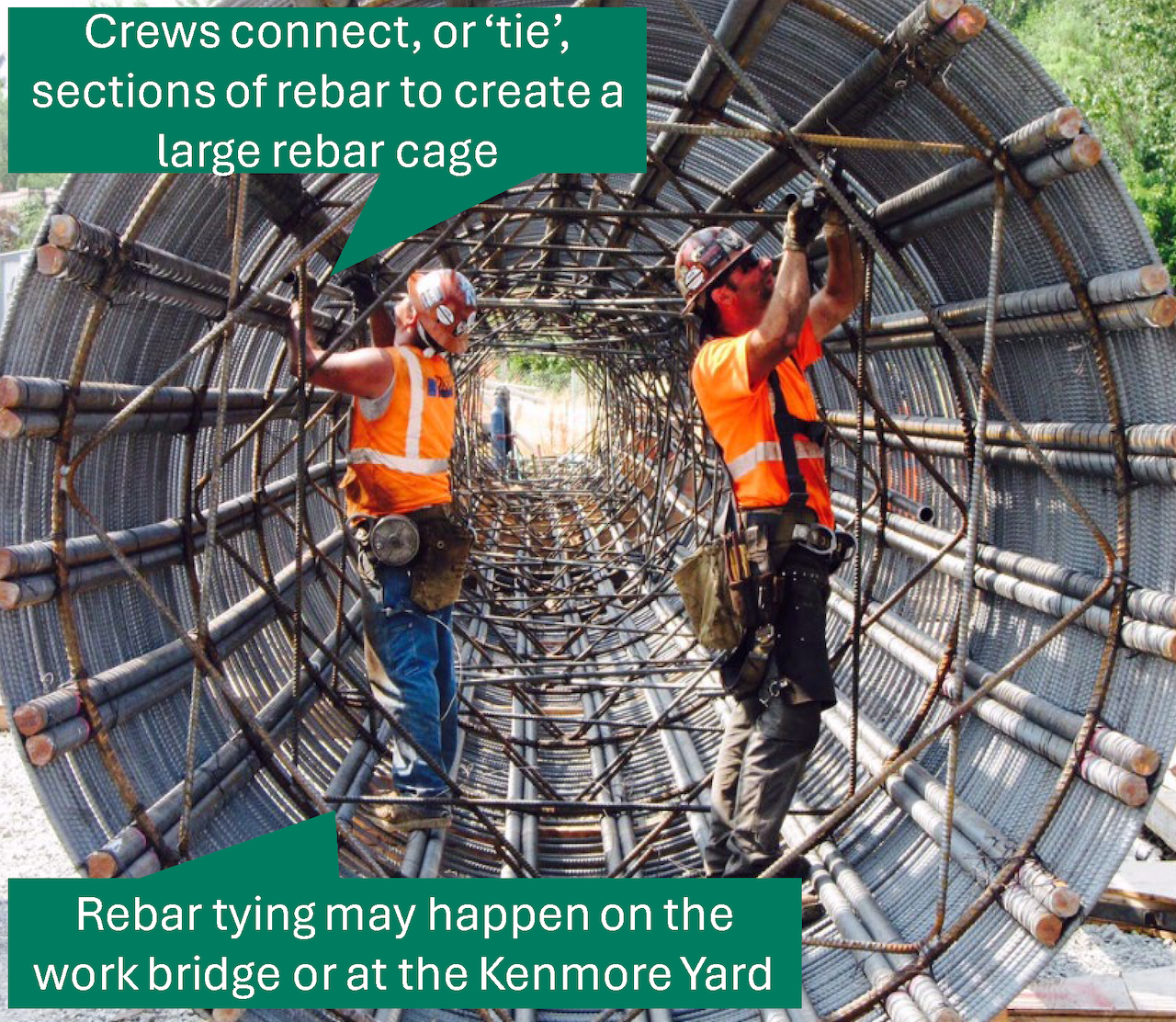

- Place a rebar support cage into each shaft. The rebar will help strengthen the foundation.
- Fill the shaft with concrete using concrete trucks and pump trucks.

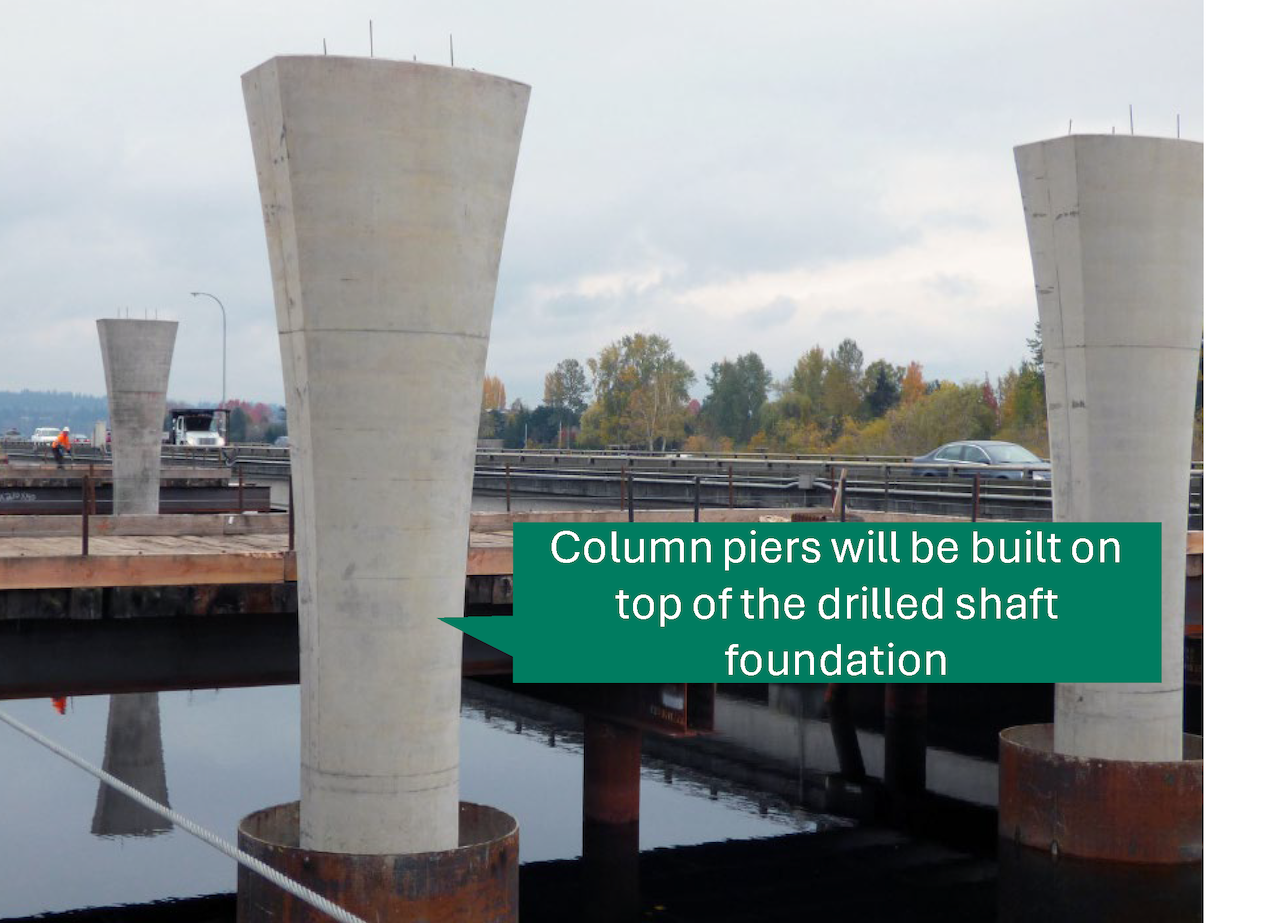

- Build and install bridge piers (vertical bridge posts) on top of the drilled shafts. We will use structural forms, reinforced steel and concrete to build each pier.
- After the bridge piers are complete, we will install the horizontal bridge superstructures (girders, decks/surfaces, etc.) on the bridge piers.
These photos are from the SR 520 West Approach Bridge North project. Crews will use the same techniques and equipment to install the drilled shafts for the Portage Bay bridges.

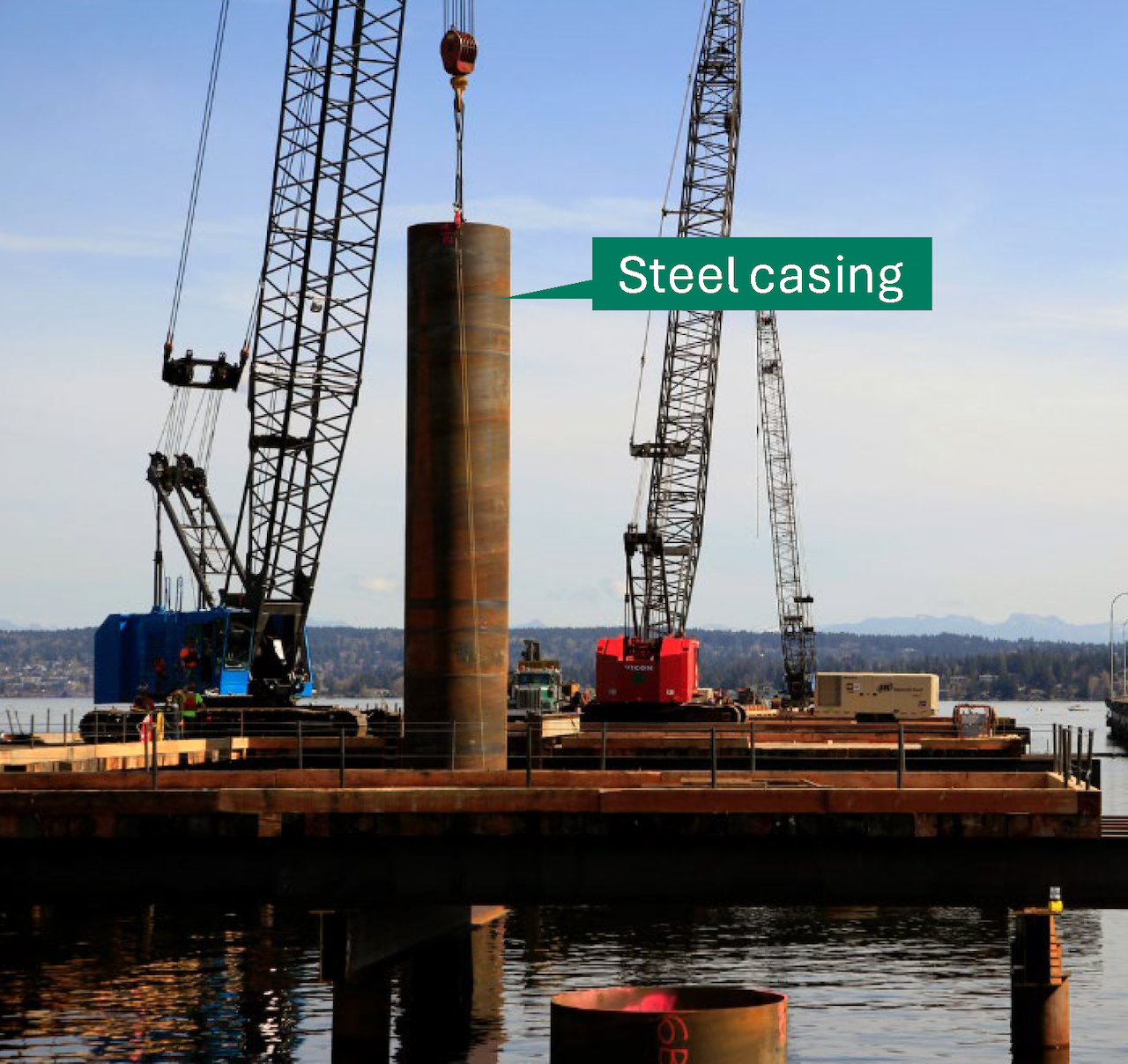

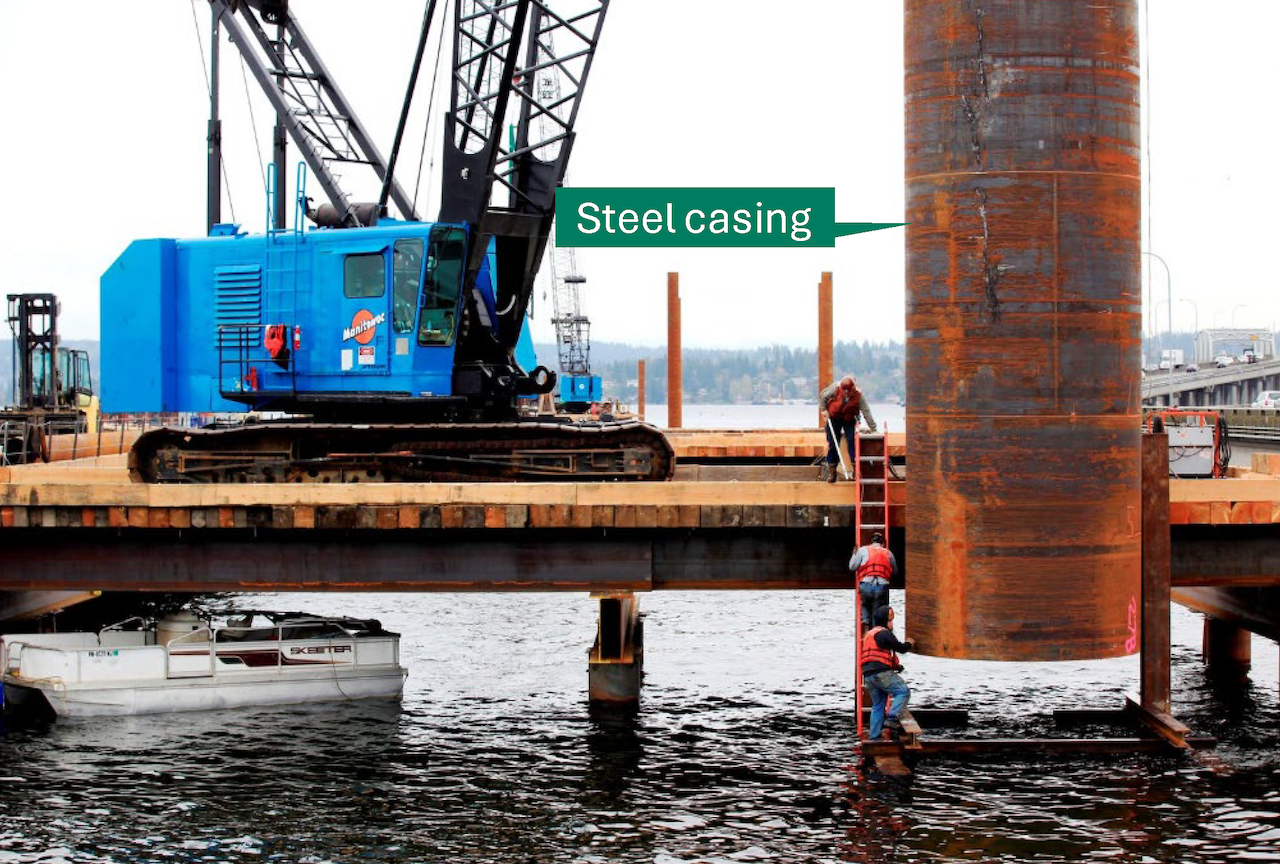

![]() A crane lowers a drilled shaft casing into place. | ![]() A closer view of a crane lowering a drilled shaft casing into place. |

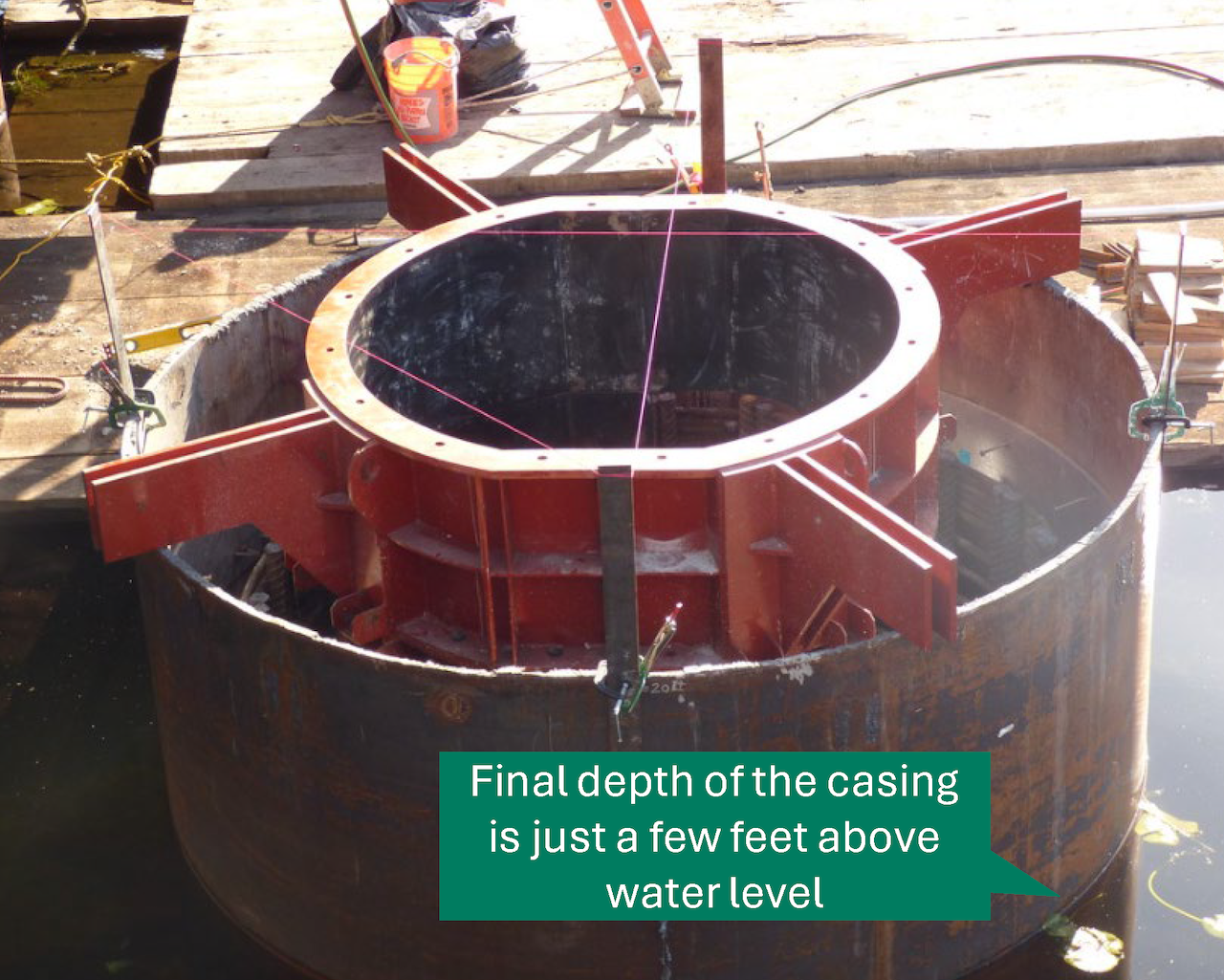

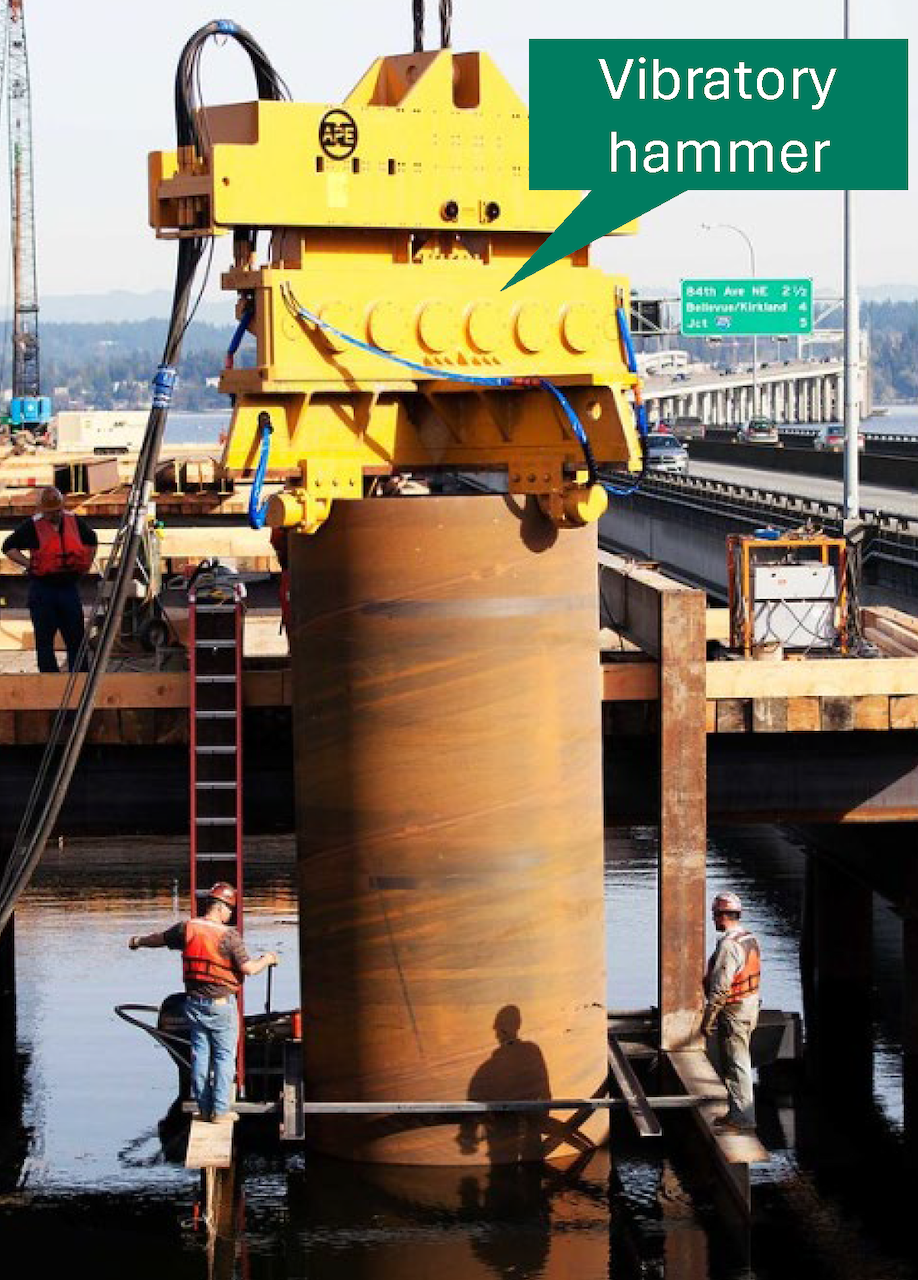

![]() Crews use a vibratory hammer to vibrate the casing into the soil. | ![]() A casing vibrated to its final depth just a few feet above the water level. |

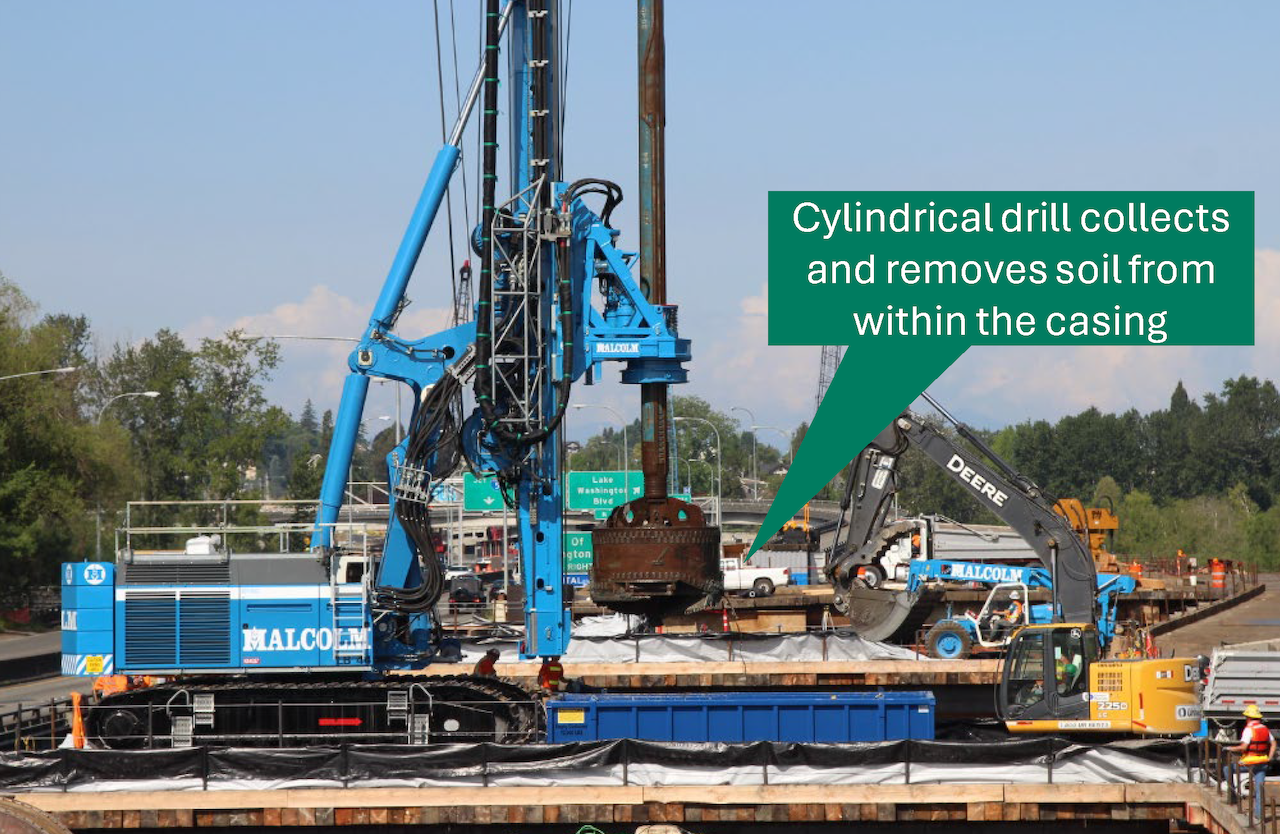

![]() A cylindrical drill used to collect and remove soil from inside the casing. | ![]() A closer view of a cylindrical drill dumping soil removed from within a casing. |
![]() A cylindrical drill moving from one casing to the next. The drilling operation will be conducted for each drilled shaft casing. | ![]() Crews using a different type of drill to remove soil from a casing. Depending on the conditions of soil inside each casing, different types of equipment may be used. |

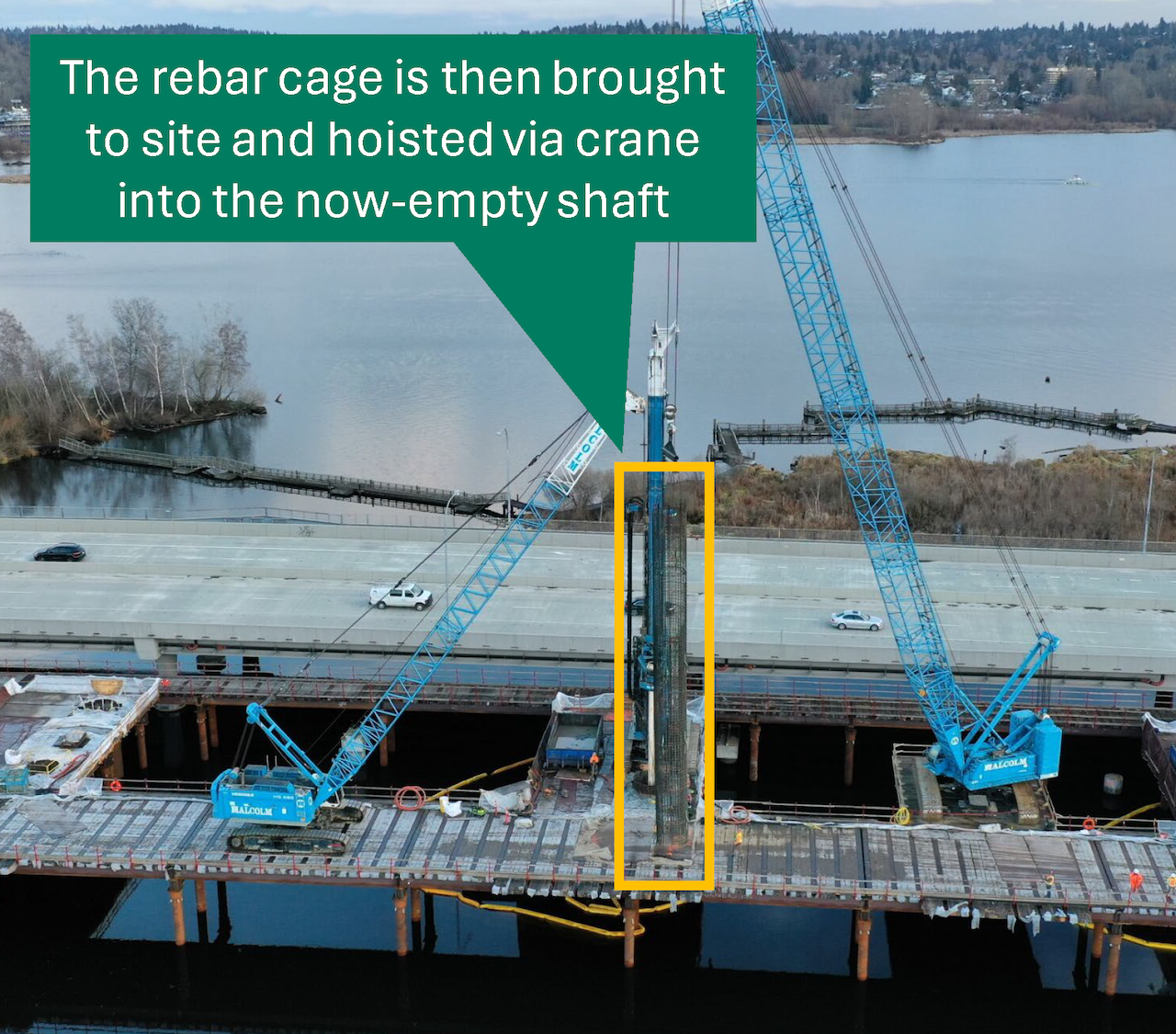

![]() Crews build a rebar cage that will be placed inside a drilled shaft. The rebar provides additional strength to the concrete that will be poured into the shaft. | ![]() Cranes lowering a rebar cage into an empty shaft casing. |

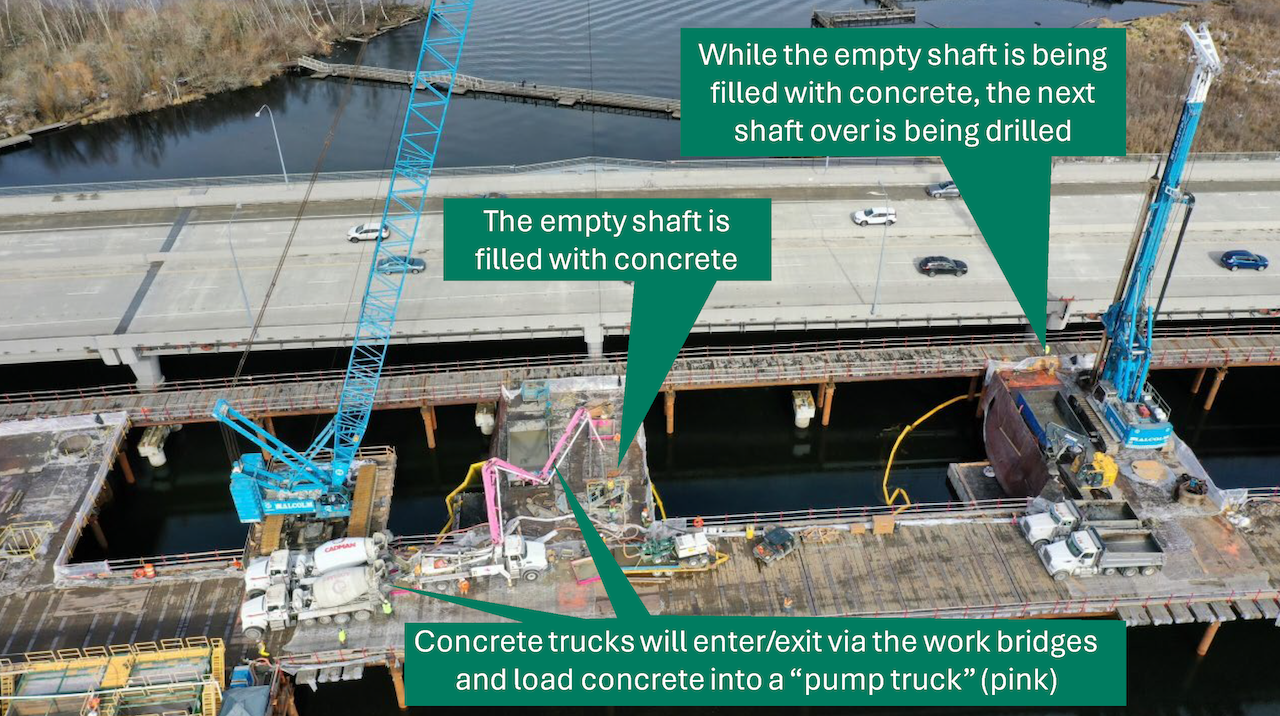

![]() Concrete trucks pump concrete into a shaft after the rebar cage has been installed. On the right side of the photo, another crew drills soil from a shaft. Crews will conduct multiple types of operations, like pumping concrete and drilling, at the same time. |

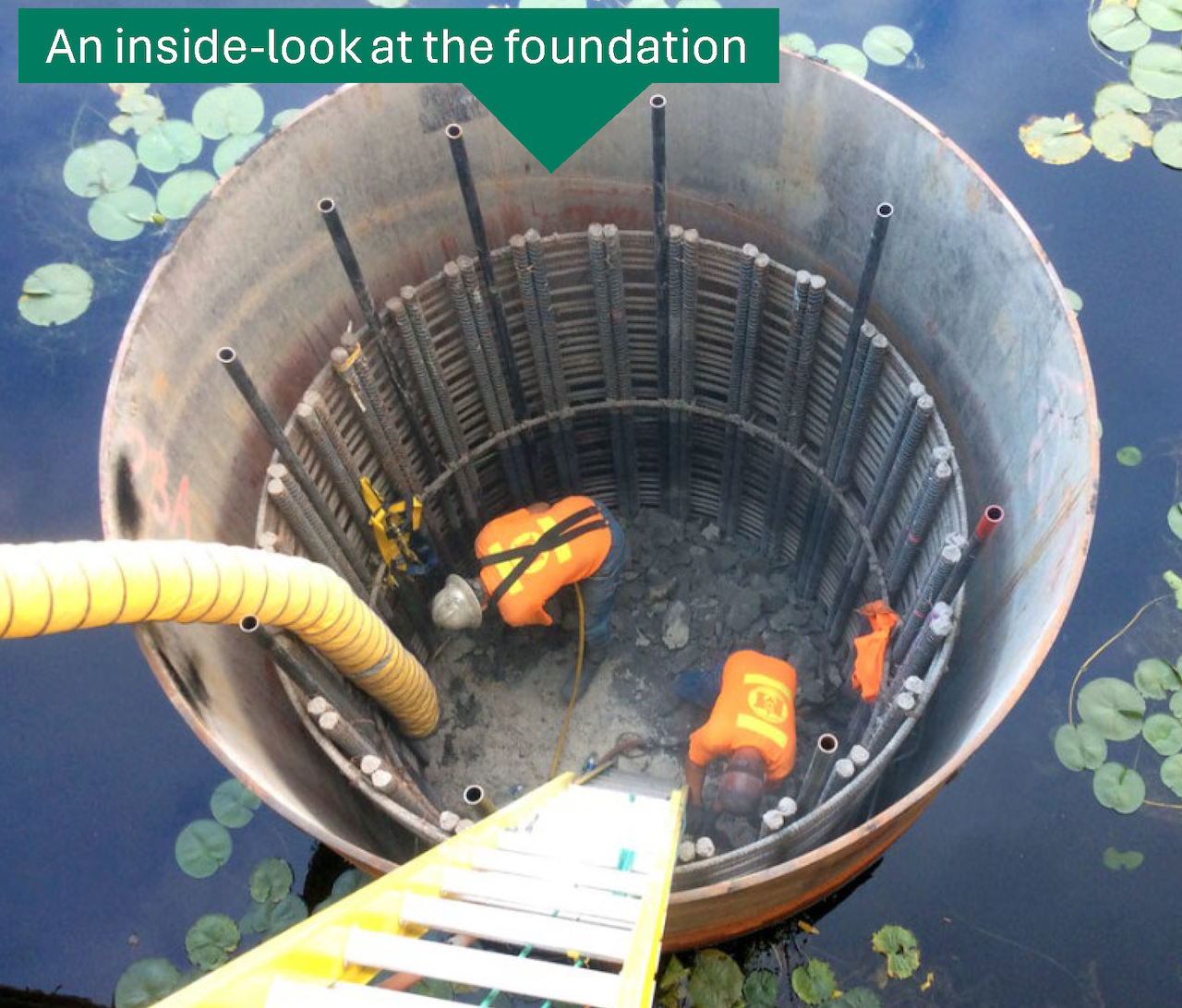

![]() A view inside a shaft filled with concrete. The top surface of the concrete and the rebar cage is visible. | ![]() Three column piers built into the top of drilled shafts. The new bridges will be built on piers like these. |
| FINALIZING THE DESIGN FOR THE NEW BRIDGES We are working to finish the design for the two bridges that will replace the existing Portage Bay bridge. Each bridge will have about 25 drilled shafts in the water. Each drilled shaft has an average casing length of 200 feet and a diameter of 12 feet. We will also install more than 100 drilled shafts on land to support structures such as retaining walls. This design is subject to change. We will share more information on the design during our monthly construction meetings once it is finalized. |
Upcoming construction
New temporary overpass near Roanoke Park
In late 2027, crews will make a big change to build the new Roanoke lid. We will remove and replace the existing 10th Avenue East and Delmar Drive East overpasses above SR 520 near Roanoke Park. The new overpasses will be incorporated into the lid structure.
To keep traffic moving during the overpass removal and replacement, we'll build a new temporary overpass. This temporary overpass will be between the existing 10th Avenue East and Delmar Drive East overpasses. We'll also build new temporary access roads from 10th Avenue East and Delmar Drive East. Once completed, we will shift traffic onto the temporary access roads and overpass for several years.
See the visual below to get an idea of how the temporary overpass will work. The exact location and phasing of this work is still under development, but it's important for neighbors and drivers to know this traffic change is coming.

A conceptual rendering showing the removal of the existing 10th Avenue East and Delmar Drive East overpasses and an approximate location for the temporary crossing over SR 520.
Shifting eastbound traffic on SR 520
Over the summer, crews installed several piles on land near the existing eastbound SR 520 off-ramp to Montlake Boulevard. These piles will support a new temporary off-ramp that will open to traffic in 2026.
WHAT TO EXPECT
- Some nighttime work so crews can build the surface of the new temporary off-ramp.
- We will fully close eastbound SR 520 over Portage Bay for at least four separate weekends and on some weeknights.
- Once construction of the temporary off-ramp is complete, we will reroute traffic onto the ramp in 2026.

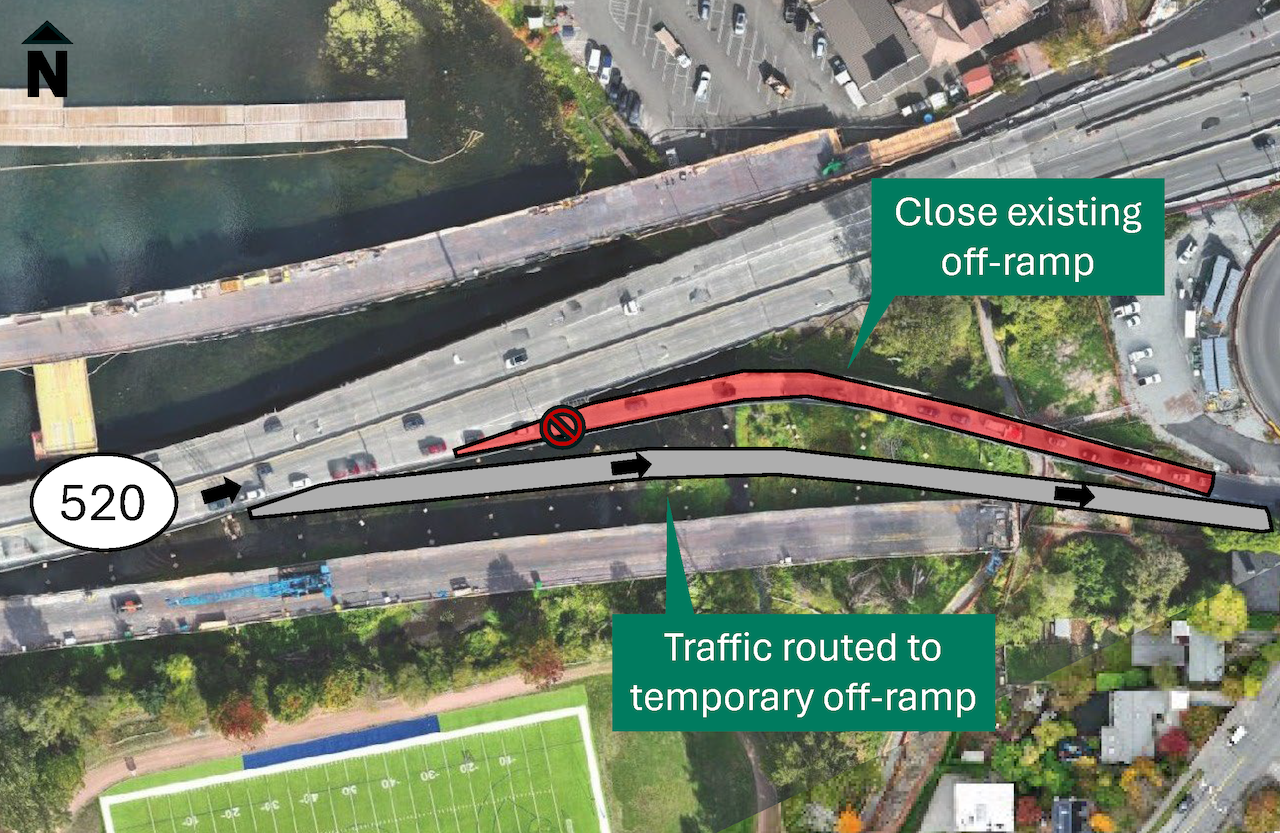

![]() Existing conditions of the eastbound SR 520 off-ramp to Montlake Boulevard | ![]() Future temporary eastbound SR 520 off-ramp to Montlake Boulevard |
Construction near Portage Bay and Roanoke Park neighborhoods
Select tree and vegetation removal
In September 2025, we updated our Tree and Vegetation Management and Protection Plan (TVMPP). You can view those updates on our Construction Corner webpage.
We initially identified trees for removal in the July 2024 TVMPP based on WSDOT's conceptual design. As Skanska furthered the design, they identified additional trees that need to be removed for several reasons, including:
- Construction of the Harvard Connection bike and pedestrian path
- Reconstruction of the East Roanoke Street/Delmar Drive East/11th Avenue East intersection, including future sidewalk, ADA ramp, curb and planter area improvements.
- Utility connections along East Roanoke Street, west of the Delmar overpass, and near the Boyer Stairs
- Design refinements to the Roanoke lid area and some of the lid's stair and ramp connections
We understand that trees and natural areas are very important to the city and nearby neighbors. We try to limit tree removal as much as possible, while still providing construction crews with the space needed to build the project.
The city of Seattle requires each tree removed within its right-of-way to be replaced with an approximate 2:1 ratio. This means that by the end of the project, we will have replaced and replanted more trees than we removed. You can read more about our process and policies for removing and replacing trees in our Tree and Vegetation Removal FAQ.

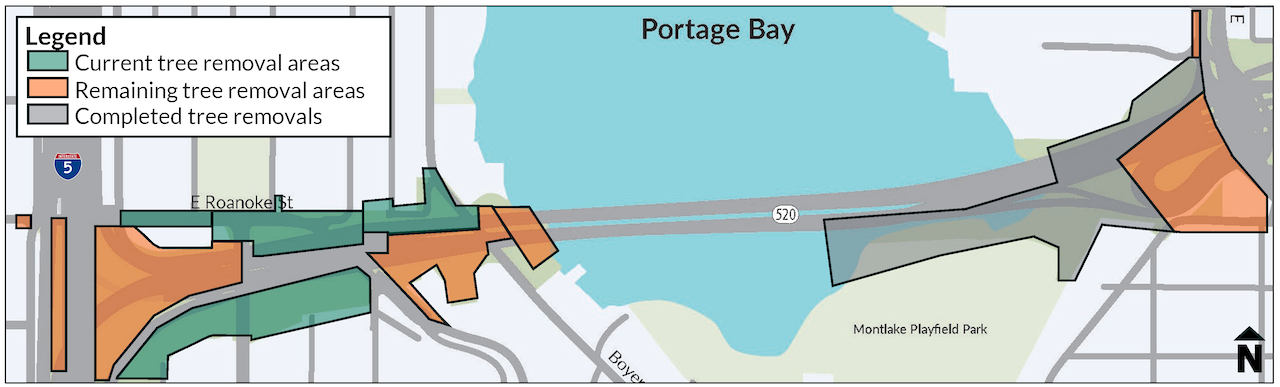

Map of areas where select trees will be removed
Tree protection notice | Tree removal notice |
Nighttime construction
Before construction began, the city of Seattle granted WSDOT and Skanska a Major Public Project Construction Noise Variance that sets limits for the allowable level of nighttime construction noise. We will get a Temporary Noise Variance when nighttime work is expected to exceed those limits. We'll also notify nearby neighbors in advance when the night work is expected to be loud and close to homes.
NOISE REDUCTION AND MONITORING:
- Crews will install temporary noise screens (called "acoustifences") for lid construction and around the WSDOT staging areas. These will be installed as the project progresses.
- Pure-tone backup alarms (the loud "beep, beep, beep" trucks often make when driving in reverse) are prohibited.
- Electronic noise meters record noise levels 24 hours a day and send real-time alerts to the project team when noise goes over the allowable levels.
- Weekly nighttime noise reports are available to the public on the SR 520 Construction Corner webpage.
- An independent noise inspector on site during all nighttime work to report any violations or stop construction work as needed.
- Other requirements as listed in the Community Construction Management Plan.
| NIGHTTIME HOURS WHEN VARIANCE IS APPLICABLE: Weekdays: 10 p.m. to 7 a.m. Weekends: 10 p.m. to 9 a.m. | For more information about the project's Major Public Project Construction Noise Variance visit sr520construction.com |

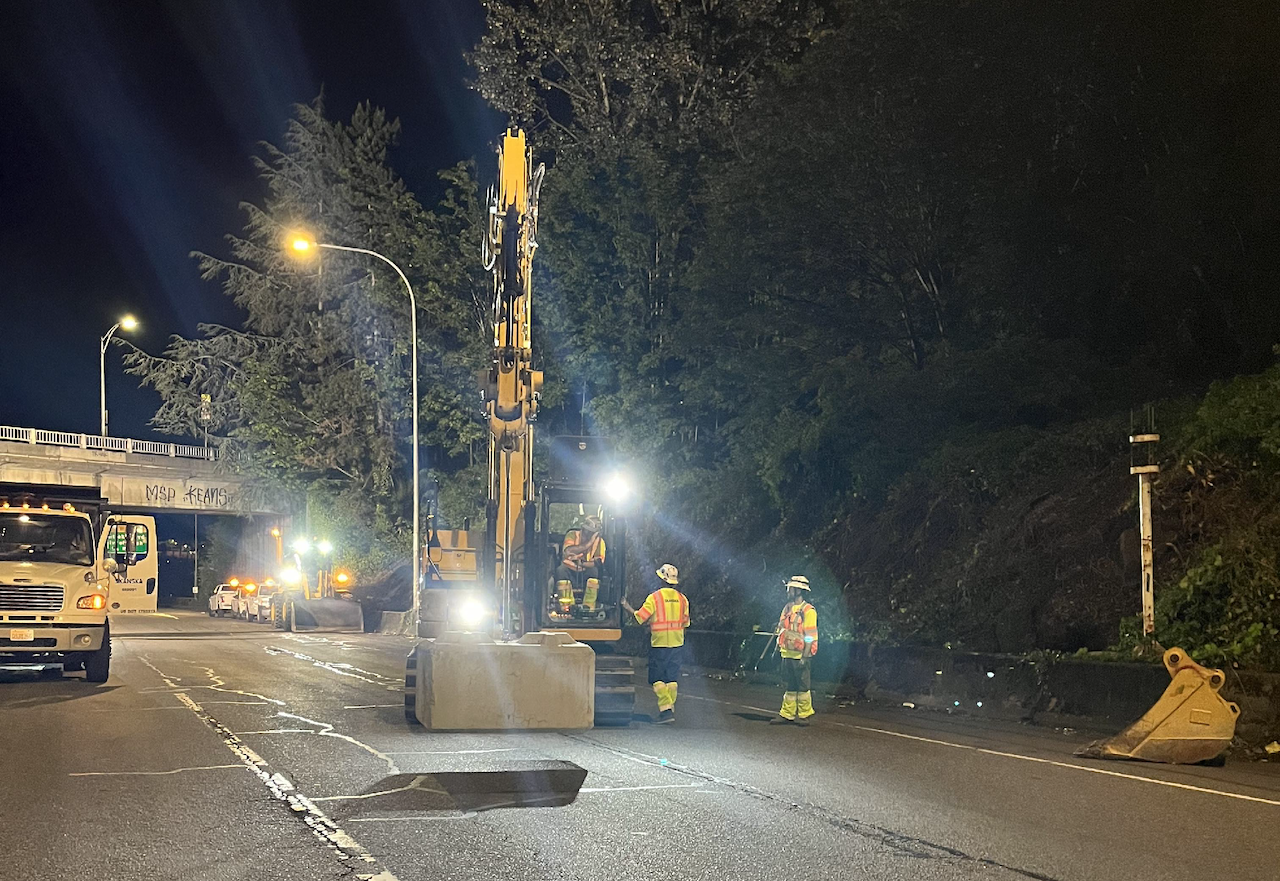

Crews move temporary traffic barriers on SR 520 at night.

Crews work overnight on SR 520.
New haul road connections and keeping people safe
To move materials and equipment to and from the temporary work trestles, we are building three temporary haul roads. These haul roads will connect the work trestle to existing streets at the following locations:
- Montlake Boulevard East will connect to the northeast corner of the work trestle.
- East Roanoke Street will connect to the southeast corner of the work trestle.
- Boyer Avenue East will connect to the southwest corner of the work trestle.
Haul roads on east side of the project
The haul road connecting Montlake Boulevard East to the northeast corner of the work trestle is now complete. We are currently building the haul road that will connect East Roanoke Street to the southeast corner of the work trestle. Crews are scheduled to begin using these new haul roads in 2026.

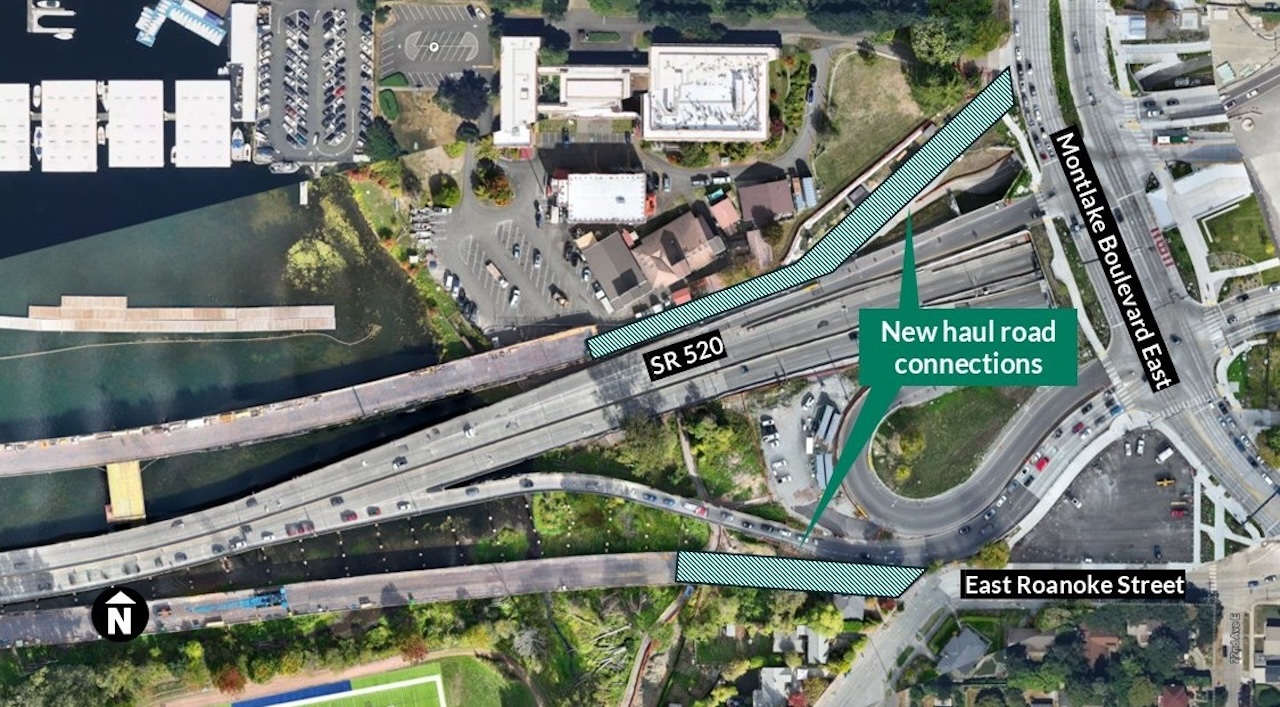

Map showing the locations of the new haul routes that will connect to the temporary work trestle on the east side of the project area.
Haul roads on west side of the project
We need to install about 20 piles in the area to extend the trestle before we build the haul road. We will begin piledriving in this area in early 2026 and continue through April 30, 2026. As the piles are installed and cut to the correct height, we will extend the deck of the work trestle, install a retaining wall on the hillside east of Boyer Avenue East and build the road connection to Boyer Avenue East.

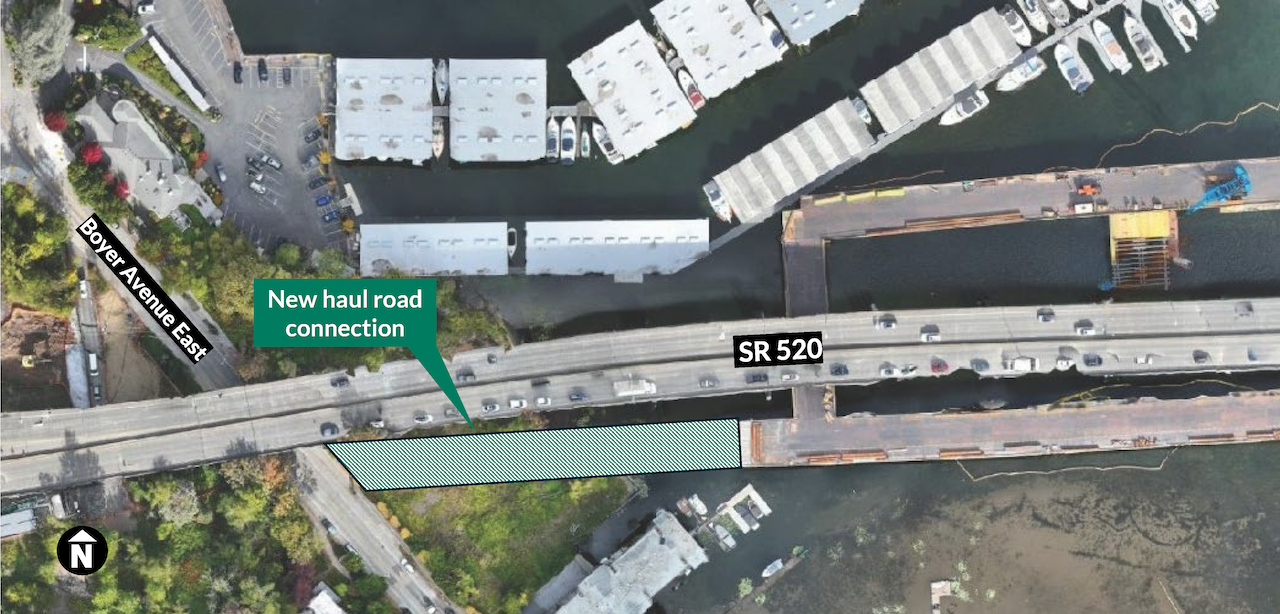

Map showing the location of the new haul route that will connect to the temporary work trestle on the west side of the project area.
The entrance to each haul road will be clearly marked with signs and cones. Because the entrance to the haul road on Montlake Boulevard East is next to the Montlake Boulevard on-ramp to westbound SR 520, we'll add the following additional safety measures to protect people traveling through this area:
- Construction fencing around active work areas
- "Construction Vehicles Only" signs near the haul road entrance
- Orange cones to separate the haul road entrance from the southbound Montlake Boulevard travel lanes and the westbound on-ramp entrance
- Orange cones across the haul road entrance to provide a clear path for pedestrians
- Flaggers on site to direct heavy trucks and larger vehicles to and from the haul road

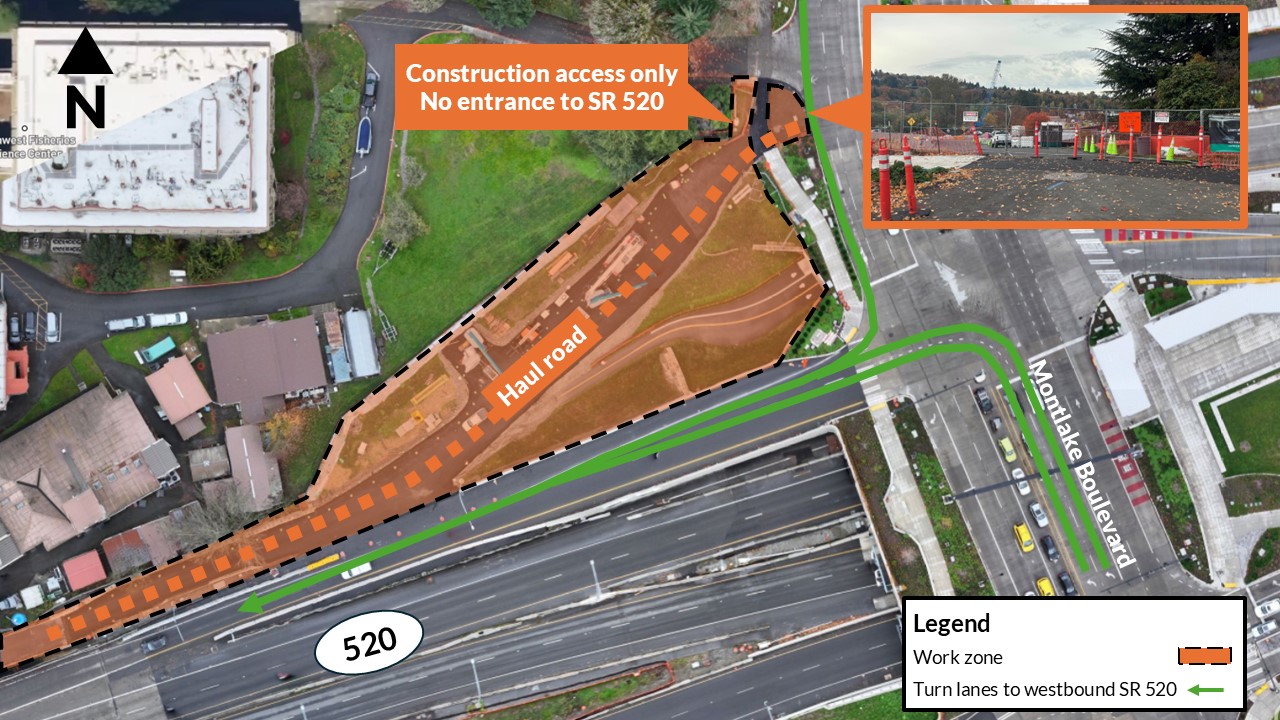

Map of the haul road entrance on Montlake Boulevard East.
Stay in touch
Thank you for taking the time to visit our online open house! We're committed to keeping you and your neighbors up to date on construction progress and what you can expect.
For questions and more information:
- Visit the Portage Bay Bridge and Roanoke Lid project website general project information.
- Email the project team at sr520bridge@wsdot.wa.gov. (inbox monitored weekdays only)
- Call our 24-hour construction hotline for questions about construction: 206-319-4520
- Sign up for the Rest of the West listserv updates for the latest news about current or upcoming construction activities Visit our Construction Corner website for the latest construction and road closure information
- Attend our monthly construction update meetings by registering at this link (updated monthly)
